Broom Street Water Main Improvement Project

Estimated Dates & Work Schedule

Anticipated Start Date: 2019-02-15
Anticipated End Date: 2019-03-29

Monday through Friday, 7:00 AM to 5:00 PM

NOTE: In some circumstances, night, weekend and extended hours may be necessary. JEA crews will not work on City of Jacksonville holidays.

Roads Affected

Broom Street, Lem Turner Road, Washington Avenue

Project Objective

JEA upgraded a portion of the existing water main on Broom Street between Lem Turner Road and Washington Avenue. This project will provide improved system reliability.

Construction Conditions

Construction will occur in the City’s rights of way, streets and easements. There will be times when the road will have limited access while the water main is being installed.  JEA will maintain the flow of traffic, although residents may experience some minor delays.

Water Outages

Some customers will experience minor interruptions to their water service.  JEA will notify customers 48 hours prior to any planned outages. Residents may also experience a brief (10 to 15 minutes) outage while crews transfer customers from the old water service to the new water service.

Restoration of the Project Area

Restoration of the project area will begin once the water main has been installed, tested and cleared for use. Upon completion of the project, any existing pavement, grass, driveways or sidewalks affected during construction will be returned to its pre-construction condition.

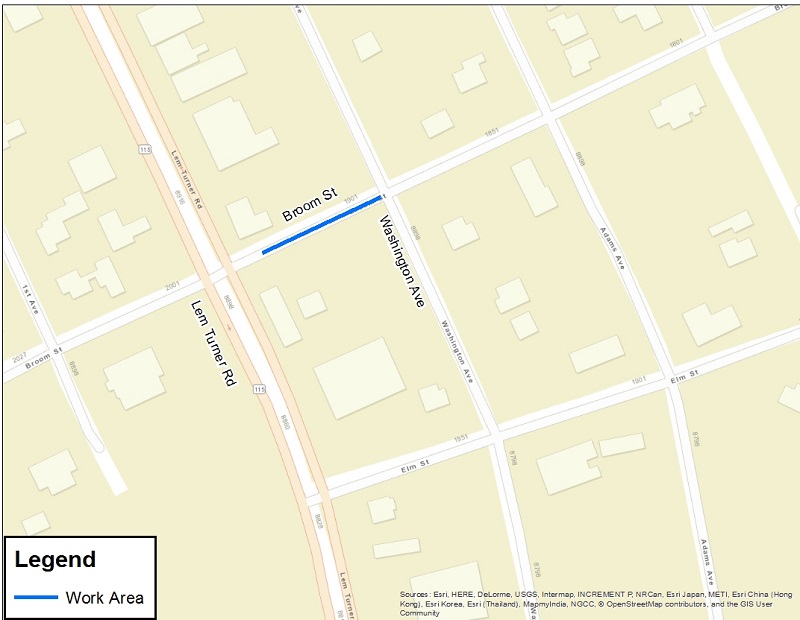

Broom Street WMIP - Map of Work Area
